Implementation Overview

The University's Strategic Plan articulates our priorities on student programming, breaking down silos, inspiring cross-campus collaboration, and process improvement. With an effective event scheduling tool, the SF State community can seamlessly collaborate, coordinate, and execute campus events, thereby fostering a vibrant campus experience. Our implementation timeline outlines the development, testing, deployment, and ongoing refinement of the tool, with a focus on enhancing accessibility and user experience. Through these initiatives, our team is committed to enhancing the University experience for all SF State stakeholders.

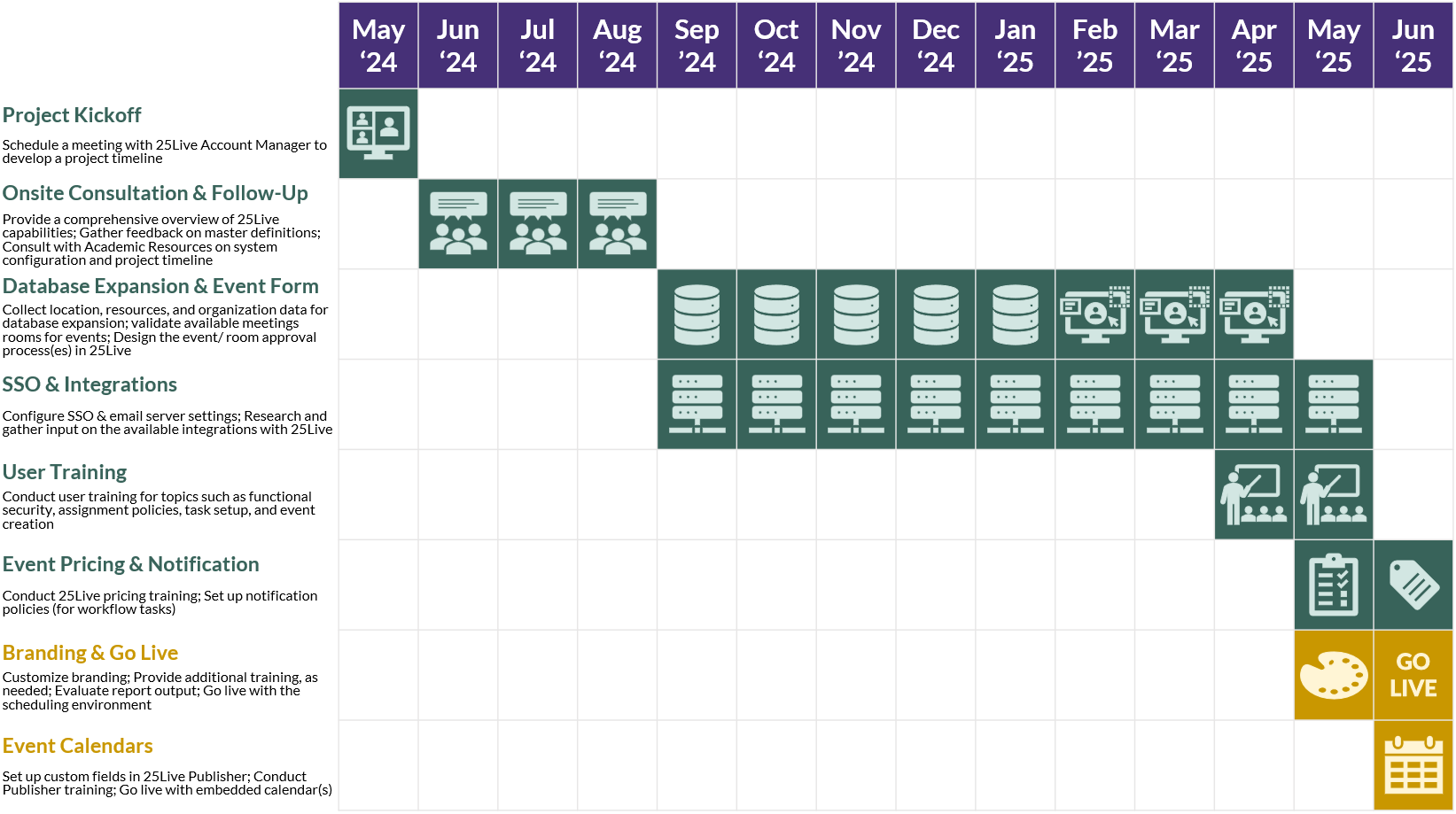

Image of 25Live implementation timeline

Project Status

In collaboration with the Event Process and Workflow Focus Group, QA will focus on developing standardized workflow templates for 25Live Event forms and approval security groups. Additionally, we are working on finalizing the security groups, which will define access levels for different campus stakeholders involved in the event planning and approval process, enhancing security and accountability.

In parallel, we are working alongside the Event Scheduling Policy and Guideline Focus Group to create an event scheduling policy. This policy aims to standardize scheduling procedures, ensuring they align with current campus guidelines and institutional policies. These efforts aim to enhance the overall coordination, efficiency, and compliance of the campus event management process.

QA coordinated with the Event Space & Feature Focus Group and Resources & Features Inventory Focus Group to gather the required data (i.e., Location, Organization, and Resources) along with critical details for the database collection. The objective is to capture the current event location inventory, resource requirements (including equipment, catering, and venue specifications), and the individuals or organizations involved in the event request process. Through comprehensive walkthroughs, QA successfully gathered the necessary location data, completing an extensive review of over 700 spaces across the academic colleges, administrative buildings, outdoor spaces, and on-campus residential buildings. This structured approach not only enhances organization but will also enable the seamless coordination and execution of events of any scale.

Single Sign-On Configuration

The SSO configuration was a collaborative effort involving QA, ITS Systems team, and Academic Resources. Its purpose was to enhance both security and administrative efficiency for the 25Live event scheduling system. By automating the provisioning process, the SSO allows campus users to access 25Live using their SF State credentials. As of September 2024, the SSO configuration has been completed, and the Academic Resources team has successfully conducted user testing in the 25Live production environment. QA and the ITS System team will continue to monitor the SSO integration and provide ongoing support to users as needed.

Process Mapping

QA collaborated with several campus venue coordinators to document their event scheduling processes. For each area, a detailed process map was created to capture the flow of tasks and responsibilities. This work helps define the roles and responsibilities involved in the event request process, identify areas of repetition and bottlenecks, and establish a baseline for further improvement. These insights will be valuable as QA assists in designing and optimizing the 25Live Event Request Form, ensuring a more efficient and streamlined workflow for event scheduling across campus.

QA worked alongside the 25Live Services Consultant to address concerns raised by Academic Resources (AR) and potential impacts on their operations. This collaborative effort involved identifying key issues, developing targeted solutions, and creating demonstrations to showcase specific system functionalities such as Object Security, Security Groups, and Assignment Policy. The detailed demonstrations highlighted 25Live system settings, configurations, and workflow customizations to ensure the system meets the department's and campus's needs. This approach also aligned with AR's priorities by adjusting the project timeline to keep the database untouched during course scheduling blackout periods and configuring a tiered workflow for requests involving AR-managed spaces. Ultimately, these enhancements will improve the effectiveness of the 25Live system, contributing to a more efficient and user-friendly experience.

The first of two in-person consultation sessions was scheduled for June 2024. The session was held on-site and attended by the Core Project team.

The primary objective was to gather comprehensive data on the University's event scheduling business processes, essential for the database buildout. Our focus lies in delving into the event scheduling workflow and ensuring alignment between our database and the intricate nuances of our processes. Below are the topics covered in each session.

Session Title Session Topics Session Date
Session 1 Service Overview  Monday, June 17, 2024
Session 2
  • Overview of Series25 Security
  • Functional Level Security
  • Assignment Policy and Notification Policy
  • Object Level Security
Monday, June 17, 2024
Session 3
  • Workflow and 25Live Tasks
  • 25Live Pricing
Tuesday, June 18, 2024
Session 4
  • Interview: Academic Schedulers
  • Interview: Event Schedulers
  • Interviews: Resource and Service Providers/Facilities/ Other Constituencies
Tuesday, June 18, 2024
Session 5 Review and Define master definitions for database  Thursday, June 20, 2024
Session 6
  • Review and Define master definitions for database
  • Discuss 25Live-Oriented Event Structure
  • Next Steps
Thursday, June 20, 2024

A Project Kickoff Meeting was held on May 2024.

In this meeting, the team brought together key campus stakeholders, including project managers and team members, to outline project goals, objectives, and timelines. The team also introduced the different teams and clarified roles and responsibilities. The meeting aimed to foster alignment among stakeholders, promote collaboration, and set the project on a path to success.

A campus representative has been identified for each building or department. This individual serves as the main contact for coordinating events and scheduling processes within their respective areas. Their knowledge on event scheduling procedures, guidelines, layouts, and inquiries is essential for the successful implementation of a unified event scheduling tool.

Following SF State Procurement's recommendation, Quality Assurance (QA) utilized the Informal Request for Proposal (IRFP) to select the campus’ event scheduling vendor. The Scope of Work (SOW) for this project was devised with the following items in mind:

  • Consultations with Information Technology Services leadership,
  • Referencing past research efforts, and
  • Engagements university members affected by these operations.

In February 2024, QA solicited proposals from three vendors for event scheduling and management services. Evaluating these proposals involved a 204-point ranking system that QA created based on factors from the 2017 needs assessment, SOW, and insights from successful event scheduling software implementations at sister campuses. CollegeNET ranked as the leading choice with 184 points, offering competitive pricing of $38,000 in ongoing costs and unlimited licenses. Considering its low cost, high scores, and proven track record in higher education, CollegeNET was chosen as the official event scheduling vendor. QA finalized the informal solicitation process in March 2024 and secured 25Live consulting and implementation services from CollegeNET.


This page will continue to be updated as we progress with the event scheduling implementation.
